Building an accurate software development project timeline is one of the hardest jobs a CTO has, and most teams are bad at it. I have shipped software for more than 20 years and co-founded Full Scale, and I still treat every timeline as a hypothesis to test, not a promise to make. A realistic timeline tracks the software development life cycle phase by phase.

The data backs that up. The Standish Group CHAOS Report has found for years that fewer than a third of IT projects finish on time and on budget. A 2012 study by McKinsey and the University of Oxford reviewed more than 5,400 IT projects and found that large software projects run 45% over budget while delivering 56% less value than predicted.

I have watched this from both sides: as the CTO writing the estimates, and as the founder of an offshore staffing company whose engineers inherit other people’s broken timelines. The patterns repeat, and so do the fixes. This guide covers why realistic software development estimates fail and the process I use to estimate projects that actually hold up. Estimates hold up better with the right team, so when you hire senior C# developers you hit fewer surprises late in a .NET build.

Creating a successful timeline requires five steps: scope definition, complexity assessment, capacity calculation, risk buffer allocation, and continuous calibration. Most failures occur because teams skip the complexity assessment and risk planning phases. Skip those, and the budget stops meaning anything. Those buffers are only as good as the underlying software development risk management, knowing which parts of the work can actually hurt you.

Infographic revealing hidden costs of poor software development time estimation, including cost data, timeline overruns, technical complexity, team burnout, and extra time for distribution teams.

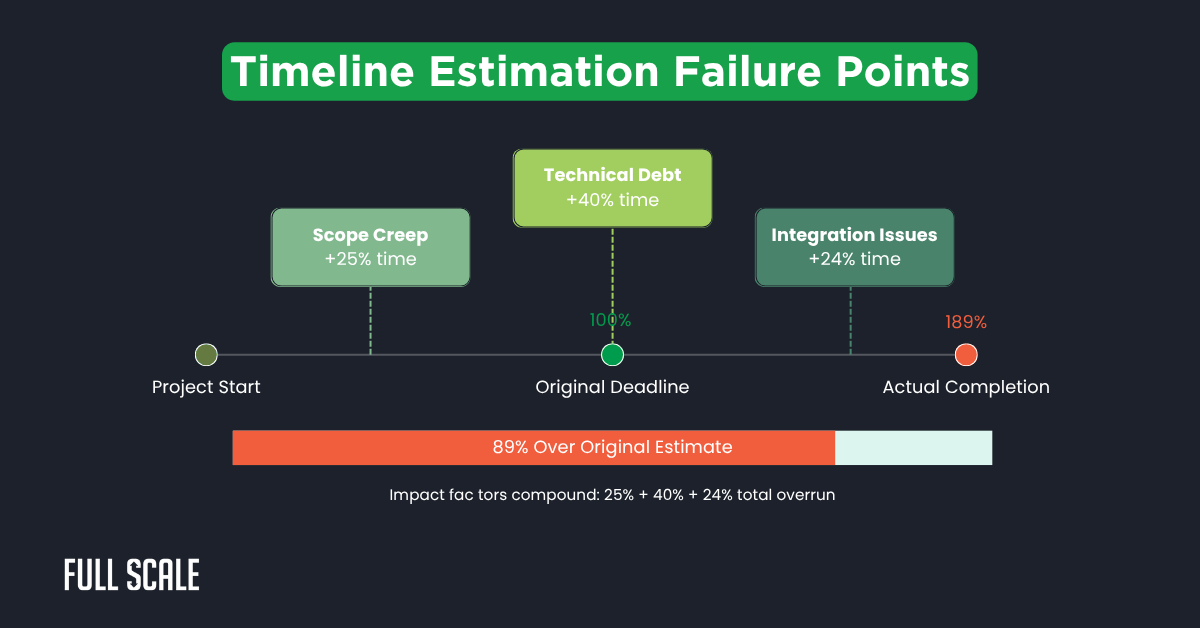

Why Software Development Project Timeline Estimation Fails

Every timeline faces predictable failure points. Software development time estimation breaks down due to optimism bias (40% underestimation), hidden technical complexity, communication overhead (25-30% in distributed teams), scope creep, and unrealistic developer resource assumptions. Of these, scope creep on a fixed timeline is the one teams underestimate most.

The 5 Critical Estimation Killers

Understanding why project timeline estimation fails helps teams avoid disasters. In 20+ years of shipping software and watching our teams inherit stalled projects, I keep hitting the same five estimation killers. Optimism bias is really the planning fallacy at work, and the percentages below are the rough ranges I see in practice, not precise lab figures:

Estimation KillerImpactHow It Destroys Timelines
Optimism Bias40% underestimationTeams assume best-case scenarios
Hidden Complexity40-75% added timeTechnical debt and integrations surprise teams
Communication Overhead25-30% productivity lossDistributed team coordination takes longer
Scope Creep50% timeline extension“Small” changes accumulate rapidly
Resource Assumptions30-40% capacity lossMeetings and admin eat development time

Estimation Method Accuracy Comparison

Different software project estimation techniques yield vastly different results, and the right one depends on your development methodology:

MethodAccuracyBest Use Case
Gut Feeling25%Never use
Expert Judgment60%Small, familiar projects
Three-Point (PERT)85%Complex projects
Historical Data90%Similar past projects

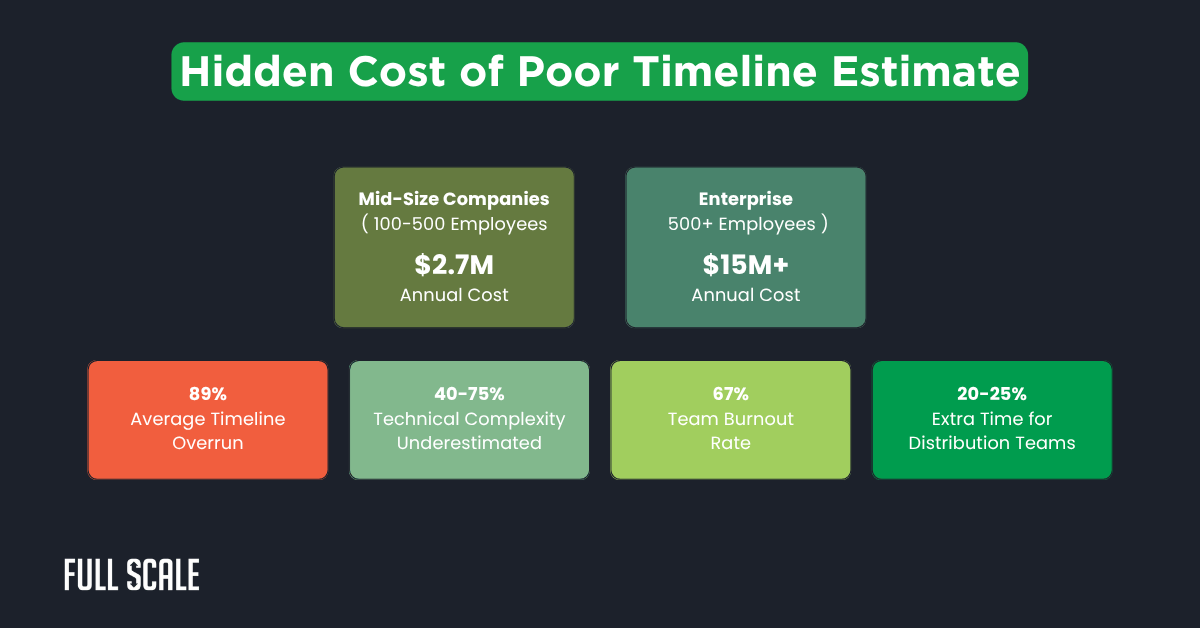

The Hidden Costs of Poor Timeline Estimation

A bad timeline costs more than the missed deadline. When you commit to a date you cannot hit, you end up cutting corners to catch up, which creates technical debt, and the slip ripples into every other plan that depended on you. The deadline is the symptom. The estimate was the problem.

Technical Debt Impact on Project Timelines

Software development project timeline accuracy depends on accounting for technical debt. Teams wondering how long software development takes must factor in legacy code:

Technical Debt LevelTimeline ImpactCodebase AgeSoftware Development Cost Impact
Low+15%< 1 year$50K-$100K additional
Medium+35%2-3 years$150K-$300K additional
High+75%Legacy systems$500K+ additional

Formula: Timeline Impact = Base Estimate × (1 + Technical Debt Factor)

Team Turnover Impact on Timelines

Chronically blown timelines burn people out, and burned-out engineers leave. When you run a project to a fantasy date, the cost eventually shows up in attrition:

  • Accurate estimation teams: 8% annual turnover
  • Poor estimation teams: 24% annual turnover (3x higher)
  • Developer replacement cost: $75,000-$150,000 per person
  • Project budget timeline correlation: Each departure adds 2-3 months

A timeline infographic shows how scope creep, technical debt, and integration issues impact software development project timeline estimation, leading to an 89% project estimate overrun beyond the original deadline.

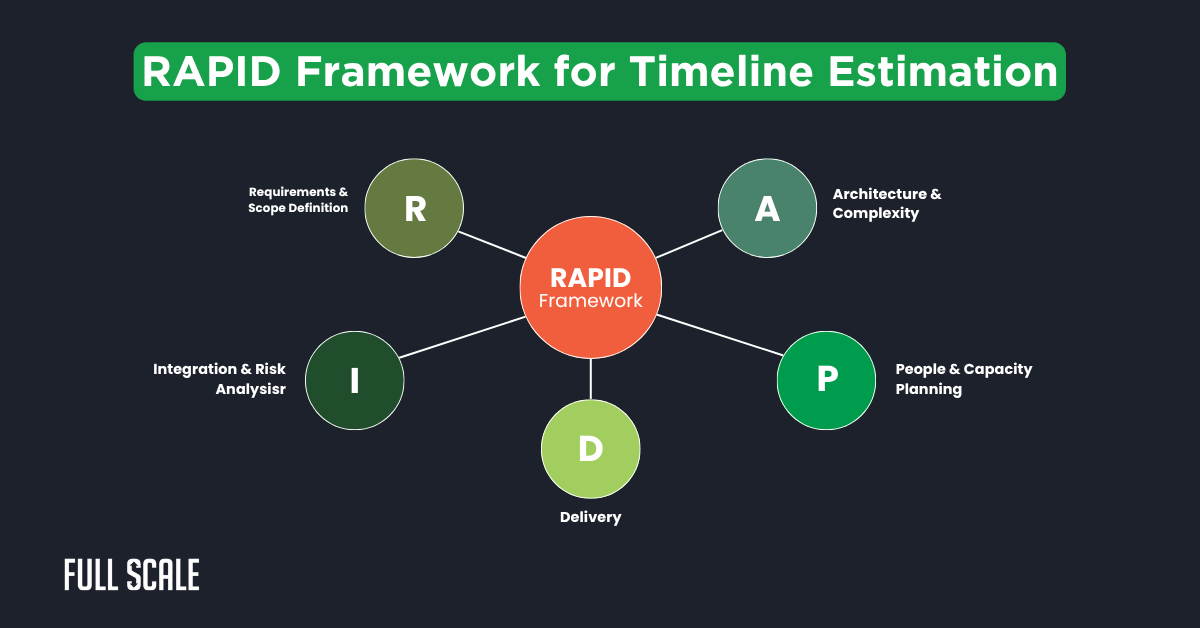

The RAPID Framework for Timeline Success

The RAPID framework is the process I walk teams through to put a defensible number on a project timeline. It runs in five steps: Requirements, Architecture, People, Integration, and Delivery. The People step is where estimates quietly fail, usually because whoever owns it got the job with no training for it, which is exactly the gap a reading list for engineering managers is meant to close. None of them is glamorous, and skipping any one of them is where most estimates fall apart.

Diagram explaining the RAPID Framework for Timeline Estimation, illustrating five components (Requirements, Integration, Delivery, People, and Architecture) for effective software development project timeline planning.

Step 1: Requirements & Scope Definition

An accurate software development project timeline starts with a crystal-clear project scope estimation. Poor requirements lead to 40% of timeline failures. Product managers must master feature development timeline estimation. Use this comprehensive checklist:

  • Detailed user stories with acceptance criteria
  • Non-functional requirements (performance, security)
  • Integration points mapped and complexity scored
  • Change management process agreed upon by all stakeholders
  • Deployment planning requirements are documented early

Change Impact Formula: Timeline Impact = (New Feature Points ÷ Team Velocity) × 1.3

Step 2: Architecture & Complexity Assessment

Technical complexity drives timeline variance. Score each component:

Complexity LevelScoreExamplesTime Multiplier
Simple1-3CRUD operations, basic UI1.0x
Medium4-6API integrations, data processing1.5x
Complex7-10Real-time systems, algorithms2.0x
New TechnologyAnyFirst-time implementation+50%
Legacy IntegrationAnyExisting system connections+75%

Step 3: People & Capacity Planning

Calculate realistic team capacity before you commit to any dates:

Formula: Effective Hours = (Available Hours × Team Size × Productivity Factor) – (Meetings + Admin)

Developer LevelProductivity FactorDistributed Team Adjustment
Senior1.0Same timezone: 0%
Mid-level0.81-4 hour difference: -10%
Junior0.65+ hour difference: -20%
New (<3 months)0.4Multi-timezone: -25%

Step 4: Integration & Risk Analysis

External dependencies destroy project timeline estimation. Add appropriate buffers:

Building a development team?

See how Full Scale can help you hire senior engineers in days, not months.

  • Technical risks: 15-25% buffer
  • Team risks: 10-20% buffer
  • External dependencies: 20-30% buffer
  • New technology: 25-40% buffer

Step 5: Delivery & Buffer Calculation

Smart buffer allocation ensures a realistic software development project timeline:

Team & TechnologyRecommended Buffer
Experienced team + familiar tech20%
Mixed experience + standard tech25%
New team + cutting-edge tech35%

Estimation Techniques That Actually Hold Up

Three-Point Estimation (PERT Method)

The most accurate software project estimation technique is three-point (PERT) estimation, which uses this formula:

PERT Estimate = (Optimistic + 4×Most Likely + Pessimistic) ÷ 6

Example: User Authentication Feature

  • Optimistic: 3 days
  • Most Likely: 7 days
  • Pessimistic: 14 days
  • PERT Estimate: 7.5 days

Planning Poker for Distributed Teams

For remote and offshore teams, including the developers we place in the Philippines, I modify standard planning poker like this:

  1. Async story review (24 hours advance)
  2. Sync estimation session (90 minutes max)
  3. Discuss outliers only
  4. Final consensus vote

Managing Risks in Your Software Development Project Timeline

Communication Overhead Formula

Communication overhead is a real tax on distributed teams, and it grows faster than headcount. Fred Brooks made this point in The Mythical Man-Month decades ago, and it still holds:

Communication Overhead = (Team Size × (Team Size – 1)) ÷ 2 × Time Factor

Team StructureTime Factor
Co-located5%
Remote (same timezone)10-15%
Multi-timezone20-25%

Quality Assurance Time Allocation

QA represents 40-60% of the development timeline planning:

  • Unit testing: 30% of dev time
  • Integration testing: 20% of dev time
  • UAT: 15% of dev time
  • Bug fixes: 25% of dev time

Tools That Help You Manage the Timeline

Essential Tool Categories

Tool TypePurposeFree OptionsProfessional
EstimationStory pointingPlanning Poker appsJira
TrackingVelocity metricsGoogle SheetsAzure DevOps
ChartsTimeline viewsMiroMonday.com
AnalysisHistorical dataExcelPower BI

Your 30-Day Plan to Fix Timeline Estimation

Implementation Roadmap

Week 1: Foundation

Week 2: Process

  • Train the team on the RAPID framework
  • Run the first estimation workshop
  • Set up tracking systems

Week 3: Application

  • Apply to the current project
  • Monitor daily results
  • Gather team feedback

Week 4: Scale

  • Adjust based on results
  • Document lessons learned
  • Expand to other teams

Get help building timelines that hold up

Good estimation is a discipline, and it is a lot easier with senior engineers who have done it before. Full Scale builds dedicated software teams in the Philippines who plug into your process and estimate like owners, not order-takers.

If your timelines keep slipping, we can help you fix the process behind them.

Schedule a call and we will talk through where your estimates are breaking down.

FAQs: Software Development Project Timeline

Why are software development estimates always wrong?

Software estimates fail due to optimism bias (40% underestimation), hidden technical complexity, communication overhead in distributed teams (25-30% loss), scope creep, and unrealistic resource assumptions.

How do you calculate software development time?

Use the RAPID framework: Define scope, assess complexity (1-10 scale), calculate team capacity with productivity factors, add risk buffers (20-35%), apply three-point estimation: (Optimistic + 4×Most Likely + Pessimistic) ÷ 6.

How much does poor estimation cost companies?

It is expensive, and the bill is bigger than the obvious overrun. Between rework, the technical debt you take on to hit a bad date, attrition, and the deals you miss while you are stuck, a chronically late roadmap can cost a mid-size company millions a year. The real number depends on your burn rate and what shipping late costs the business.

What’s the most accurate software estimation technique?

Three-point estimation (PERT) combined with historical velocity data provides 85-90% accuracy. This method accounts for uncertainty while using past performance for calibration.

How do distributed teams affect timeline estimation?

Distributed teams require 10-25% additional time depending on timezone differences. Same-timezone remote teams need 10-15% extra, while multi-timezone teams need 20-25% additional time.

What factors affect development timeline the most?

Technical complexity (40-75% impact), scope changes (50% extension), team experience, external dependencies, and communication overhead for distributed teams significantly affect timelines.

How to create realistic project estimates for agile teams?

Use sprint planning with historical velocity, apply PERT estimation, include buffer for iteration cycles, and adjust for team capacity planning and technical complexity.

What is three point estimation in project management?

Three-point estimation calculates expected duration using optimistic, pessimistic, and most likely scenarios. Formula: (O + 4M + P) ÷ 6, providing probabilistic accuracy.

How to use PERT estimation effectively?

Gather three estimates per task, apply the formula, aggregate results, add risk buffers, and validate against historical data for similar projects.

Agile estimation vs waterfall timeline – which is better?

Agile allows iterative refinement with 15-20% better accuracy due to continuous feedback, while waterfall works for fixed-scope projects with clear requirements.

How much buffer time to add to estimates?

Add 20% for experienced teams on familiar tech, 25% for mixed teams, 35% for new teams/technology, plus 10-25% for distributed team coordination.

What causes software projects to be late?

Underestimating technical complexity (40-75% impact), unplanned scope changes, resource allocation issues, external dependencies, and poor risk assessment cause delays.Q: How long does software development take for different project sizes? A: Software development project timeline varies: Small projects (3-6 months), medium projects (6-12 months), large enterprise projects (12-24+ months), varying by complexity, team size, and scope definition.
